Due Diligence Survey Before a Developer Buys the Last Undeveloped Parcel in a Built-Out Area

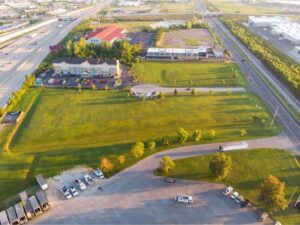

Every built-out area seems to have one. It’s the vacant lot between a gas station and an office park that somehow never got developed. For a developer, that parcel can look like a rare chance to build where demand already exists.
There’s usually a reason it’s still empty, though. An odd shape, unclear access, a drainage easement, or a boundary gap with the neighbors can keep land sitting for decades. A due diligence survey before closing tells you which of those problems you’re buying, so you can price them in, fix them, or walk away.
Why the Last Undeveloped Parcel Requires Extra Due Diligence
A due diligence survey is a field survey done before purchase to show what’s actually on and around a property. It often covers boundary lines, easements, access, improvements, and ground conditions. Depending on the deal, it may be an ALTA/NSPS land title survey, a boundary survey paired with a topographic survey, or a custom scope set by the buyer and lender.
Leftover parcels carry more unknowns than typical raw land. Neighbors built around them and sometimes used the empty lot for drainage, overflow parking, or a shortcut driveway. The records may also be older or less consistent, because the parcel may not have changed hands in years.
Each nearby project left its mark on paper too. Plats, dedications, and easements from surrounding developments can reach onto the parcel. A careful survey pulls those threads together before your money is at risk.
Verify Boundaries Against Surrounding Built-Out Properties
Boundary work on an infill parcel means checking your lines against every neighbor that’s already built. The surveyor finds monuments, reviews deeds and plats for the parcel and adjoining lots, and measures where fences, curbs, and buildings actually sit. Where the records and the ground don’t agree, the survey shows the difference.
Common Boundary Problems on Leftover Parcels
Surrounding development tends to create the same handful of issues. Most of them are fixable if they’re found early. Watch for these on the survey drawing:
- Gaps or overlaps between the parcel’s deed and a neighbor’s plat
- Fences, parking, or landscaping from adjoining sites that cross the line
- Missing or disturbed monuments from past construction nearby
- A recorded acreage that doesn’t match the measured area
Small differences can matter a lot on a tight site. Losing a few feet along one side can change setbacks, parking counts, or building size. Share any boundary issues with your title company and attorney, since they’ll guide how the purchase handles them.
Identify Access, Easements, and Utility Constraints Before Closing
Access is the first thing to confirm on a parcel that looks boxed in. The survey should show whether the land touches a public right-of-way, which is land set aside for a street, and exactly where that frontage sits. If access depends on a private drive through a neighbor’s site, you’ll need a recorded easement that gives you that right.
Easements are the second big check. An easement is a legal right for someone else to use part of your land for a set purpose, such as a utility line or a drainage channel. The surveyor plots each recorded easement from the title commitment so you can see how much buildable area is really left.
Utilities to Locate
Utilities shape what you can build and what it will cost. The survey can show visible features like manholes, valves, poles, and meters, and your engineer uses them to trace service lines. Confirm these items early:
- Location and depth of nearby water, sanitary sewer, and storm lines
- Whether existing lines have capacity for the planned use
- Overhead or buried lines crossing the parcel
- Any lines found in the field that have no recorded easement
Unrecorded utilities are a real risk on older infill ground. A line can cross the parcel with nothing on record, and moving it can be slow and expensive. Private locate services and the utility providers can help confirm what the survey finds.
Review Topography and Existing Site Conditions for Development Feasibility
A topographic survey maps the shape of the ground with spot elevations and contour lines. On a leftover parcel, it often explains why the land sat empty. Low spots, steep grades, or fill dirt dumped during nearby projects can all raise site costs.
Drainage deserves close attention. Surrounding sites may send runoff onto the parcel, and your project may need to accept that flow or route it safely. The engineer uses survey elevations to design grading and detention that tie into existing curbs, inlets, and neighboring pads.
Floodplain mapping is another check. The surveyor can show any mapped flood zone on the drawing, and your civil engineer can explain what it means for building and permitting. Rules vary by city and county, so confirm them before you commit to a site plan.
Look for signs of past use while you’re at it. Old slabs, buried debris, and stockpiled dirt are common on lots that sat next to active construction. The survey records what’s visible, and a geotechnical or environmental consultant can check what’s below the surface.
Use Survey Findings to Reduce Acquisition and Site Planning Risk
A due diligence survey only helps if you get it back before your option or feasibility period ends. Order it as soon as the contract is signed. Give the surveyor the title commitment, the survey terms in your purchase contract, and your lender’s requirements so the scope matches what everyone needs.
Once the survey is done, sit down with your team and sort the findings. Some issues can be cured by the seller, some can be handled through title coverage, and some change the price or the deal itself. A clear drawing makes those conversations faster and far more concrete.
The survey also becomes the base map for site planning. Your engineer and architect can start concept layouts from real lines, easements, and elevations. That cuts down on redesign later and gives the planning office a cleaner first submittal.
Frequently Asked Questions
What does a due diligence survey include?
The scope depends on the property, the lender, and the buyer’s goals. Most include boundary lines, recorded easements, access, visible improvements, and visible utilities. Many developers add topographic data so engineers can judge grading and drainage. Talk with your surveyor about the scope before field work begins.
Is an ALTA survey required when buying land?
It isn’t always required. An ALTA/NSPS survey is common when a lender or title company wants extended coverage, and it’s often used in commercial deals. Some buyers of raw land choose a boundary and topographic survey instead. Your lender and title company will tell you what they need for your purchase.
How early should I order the survey?
Order it as early as you can, ideally right after the contract is signed. Research, field work, and drafting all take time, and infill parcels often need extra record research. Many problems can only be negotiated if they’re found during the option period. Waiting until the week before closing leaves very little room to respond.
